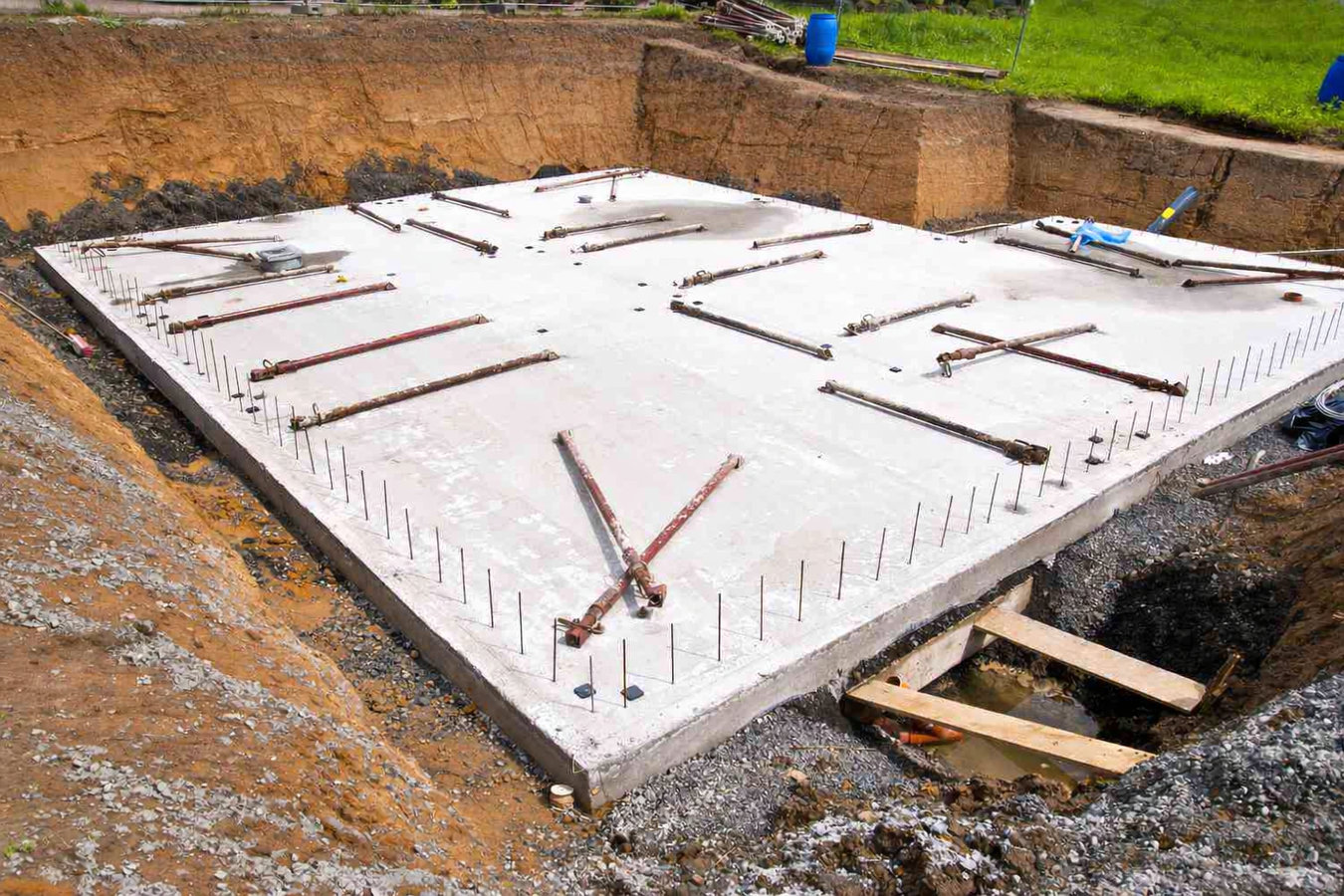

Lafayette's alluvial clay soils swell, shift, and hold moisture year-round. Every footing we pour is sized for the actual soil conditions, reinforced to ACI 318-19 standards, and held until a Lafayette inspector signs off before any concrete is placed.

Concrete footings in Lafayette involve trench excavation, dewatering if the water table is high, reinforcing steel placement to ACI 318-19 specifications, a city inspection hold point, and the concrete pour itself — residential footing phases typically span 3 to 7 business days from permit to placed concrete.
The reason footings matter more in Lafayette than in most inland markets comes down to two things: alluvial clay soils and flood zone exposure. Lafayette Parish is underlain by Holocene and Pleistocene alluvial clays that expand when wet and contract when dry. That shrink-swell cycle exerts lateral and uplift pressure on footings not sized to resist it, and it is the primary reason concrete work in Acadiana shifts or cracks over time when the footing was undersized or poured into inadequately prepared soil. On top of that, Lafayette Consolidated Government's floodplain management requirements affect footing height design on most new construction in the parish's lower-lying zones, requiring the lowest structural floor to sit at least one foot above the Base Flood Elevation.
When a structure also needs a full foundation installation above the footings — stem walls, grade beams, or a complete slab system — we handle both phases so the footing dimensions and reinforcement are designed together with the foundation system that sits on them. For projects that include concrete retaining walls, the footing design is especially critical because the wall resists lateral soil pressure from the outset, and that load path begins at the footing.
Diagonal cracks appearing at door or window corners, or cracks running through a concrete slab, can indicate that the footings beneath have moved or settled unevenly. In Lafayette, this is frequently traced to alluvial clay soils shifting as moisture levels change under the structure. Catching it early — before the cracks widen or doors begin sticking — limits the scope of what needs to be done.
When a door that used to close cleanly starts catching or dragging on the frame, the structure above has shifted. Footings that were undersized for the soil conditions or poured without adequate reinforcement can allow differential settlement — where one part of the foundation moves more than another — producing exactly this symptom. Horizontal cracks in masonry near grade are another sign that lateral soil pressure has overcome the footing.
Standing water in a foundation trench or persistent moisture beneath a structure means the footing is in contact with saturated soil. Lafayette's high water table means footing excavations frequently encounter groundwater within the first 18 inches of digging. Footings poured into wet trenches without proper dewatering have inadequate cover over the reinforcing steel, which leads to corrosion and structural compromise over time.
Any new load-bearing addition — a room, a covered porch, a carport, or a detached structure — requires a properly sized footing matched to the load it will carry and the soil conditions at the site. Tying new construction into an existing structure without confirming the footing capacity on both sides creates differential settlement risk from the first rainy season.
The most common footing type for residential construction in Lafayette is the continuous strip footing — a concrete beam running beneath load-bearing walls that distributes wall loads along its length. Strip footings for residential work here are typically sized 12 to 18 inches deep with #4 or #5 Grade 60 rebar spaced at or below 18-inch centers, with a minimum 3-inch cover on the bottom face where the steel contacts ground. That cover requirement is not optional: ACI 318-19 mandates it specifically because corroded rebar in a footing loses its ability to resist tension loads.
Where columns or posts carry point loads rather than distributed wall loads, spread (isolated) footings are specified. Their dimensions are calculated based on the column load and the allowable bearing pressure of the soil at that location — a number that varies significantly across Lafayette Parish depending on whether you are on firmer upland soils or softer alluvial material near drainage corridors.
Many new construction projects in Lafayette's flood-prone zones require grade beams or stem wall systems rather than a monolithic slab, because the structure's lowest floor must be elevated above the Base Flood Elevation. This changes both the footing geometry and the reinforcement requirements substantially from what a standard residential footing spec would call for. A foundation installation that incorporates a grade beam system needs its footing designed as an integral part of the full structural system, not as a separate element. For structures that also rely on retaining walls to manage grade changes on the site, the footing for each wall is sized to resist the lateral pressure of the retained soil in addition to its own weight.
The standard choice for load-bearing walls; runs the full length of the wall and distributes load evenly across the soil bearing surface.
Used beneath individual columns or posts; sized based on column load and allowable soil bearing pressure at the specific site.
Required on many Lafayette sites to elevate the lowest floor above the Base Flood Elevation; changes footing geometry and reinforcement requirements from a standard monolithic design.
Used where column loads are closely spaced or soil bearing capacity is low; distributes the total structural load across a larger footprint to stay within allowable pressures.
Lafayette Parish sits in the Vermilion-Teche watershed, where subsurface moisture levels remain elevated year-round and footing excavations frequently hit standing water within the first 18 inches. That is not an outlier condition here — it is the norm in much of the parish, particularly in the southern and southwestern growth corridors where an investigation by The Current LA found that nearly half of new developments built between 2001 and 2021 occurred in flood-prone areas historically avoided for exactly this reason.
The 2021 Louisiana Residential Code, Chapter 4 requires all exterior walls to be supported on continuous concrete or masonry footings designed to transmit loads to the soil within its allowable bearing capacity. The Louisiana Building Code's Chapter 18 soils and foundations provisions allow the building official to require soil classification when site conditions are uncertain — a provision that gets exercised more often in Lafayette than contractors working in other markets might expect.
We work across the full Lafayette service area, including newer construction in Broussard, Youngsville, and Scott, where residential subdivision growth has moved into lower-lying areas with softer soil profiles. The footing specifications on those sites often need to go wider or deeper than standard residential tables suggest, because the alluvial material near the surface carries less load than the tables assume.
Reach us by phone or through the contact form. We respond within 1 business day to gather details about your project type, site location, and any existing structural information. A quick conversation helps us determine whether a soil assessment or engineer referral should precede the estimate.
We visit your property to assess soil conditions, confirm site drainage and flood zone status, and review any existing plans or permit requirements with you. The written estimate you receive covers concrete strength, rebar grade and spacing, footing dimensions, depth, and any dewatering scope — with no obligation to proceed. If your site requires a geotechnical report, we discuss that here, not mid-project.
We pull the permit through Lafayette Consolidated Government before any ground is broken. Once the permit is issued, we excavate the trench, dewater if necessary, set forms to the specified dimensions, and place reinforcing steel to ACI 318-19 requirements. Nothing is poured until the LCG inspector has reviewed and approved the formed, reinforced footing.
Concrete is placed after the inspector approves the trench. During summer months, we schedule pours in the early morning and apply wet-curing methods to protect the footing from heat-related surface drying. We remain on-site through initial set and document the pour for your project records. LCG sign-off is obtained before we leave the project.
We evaluate footing scope, flood zone status, and soil conditions at no charge. Call us or submit a request and we will respond within 1 business day.
(337) 483-1560Pouring concrete over an uninspected footing in Lafayette can mean a mandatory tear-out at your cost. We treat the LCG footing inspection as a non-negotiable hold point on every project, so your permit closes correctly and your investment is protected from the start.
Lafayette Consolidated Government's flood elevation requirements affect nearly every new footing in the parish's lower-lying zones. We cross-reference FIRM panel data before any design is finalized to confirm whether a stem wall or grade beam is required to meet the one-foot-above-BFE rule — a detail that cannot be corrected after the concrete sets.
Reinforcing steel in footings must maintain a 3-inch minimum cover on the bottom face and be spaced no more than the lesser of 18 inches or 1.5 times the footing thickness. We follow ACI 318-19 requirements on every pour and document rebar grade, spacing, and cover in writing for your project file.
Our license under the Louisiana State Licensing Board for Contractors is current and verifiable at lslbc.gov. We have poured footings across Lafayette Parish and the surrounding communities, including work in the southern and southwestern subdivisions where newer development has pushed into softer alluvial clay profiles that demand more careful attention to bearing conditions.
A footing is the one part of a concrete project that cannot be inspected or corrected after the structure is built on top of it. Getting the bearing depth, rebar placement, and flood compliance right the first time is not a differentiator — it is the baseline. What separates a reliable contractor from an unreliable one in this market is whether they treat it that way on every job, regardless of project size.
